Skip to content
Delivered to all 50 states 24/7 dispatch: (888) 828-7765

Crews, camps and remote job sites

Bunkhouse Sleeper Trailer Rentals Nationwide

Your crew sleeps a short walk from the work instead of an hour down the highway. No long commute. No scramble for rooms. The 12-Station Bunkhouse Sleeper Trailer puts 12 heated and air-conditioned bunks on your pad, delivered and set up level before the first shift. We place them at remote construction pads and storm staging yards in all 50 states. Call (888) 828-7765 any hour, or send your dates and headcount for a fast quote.

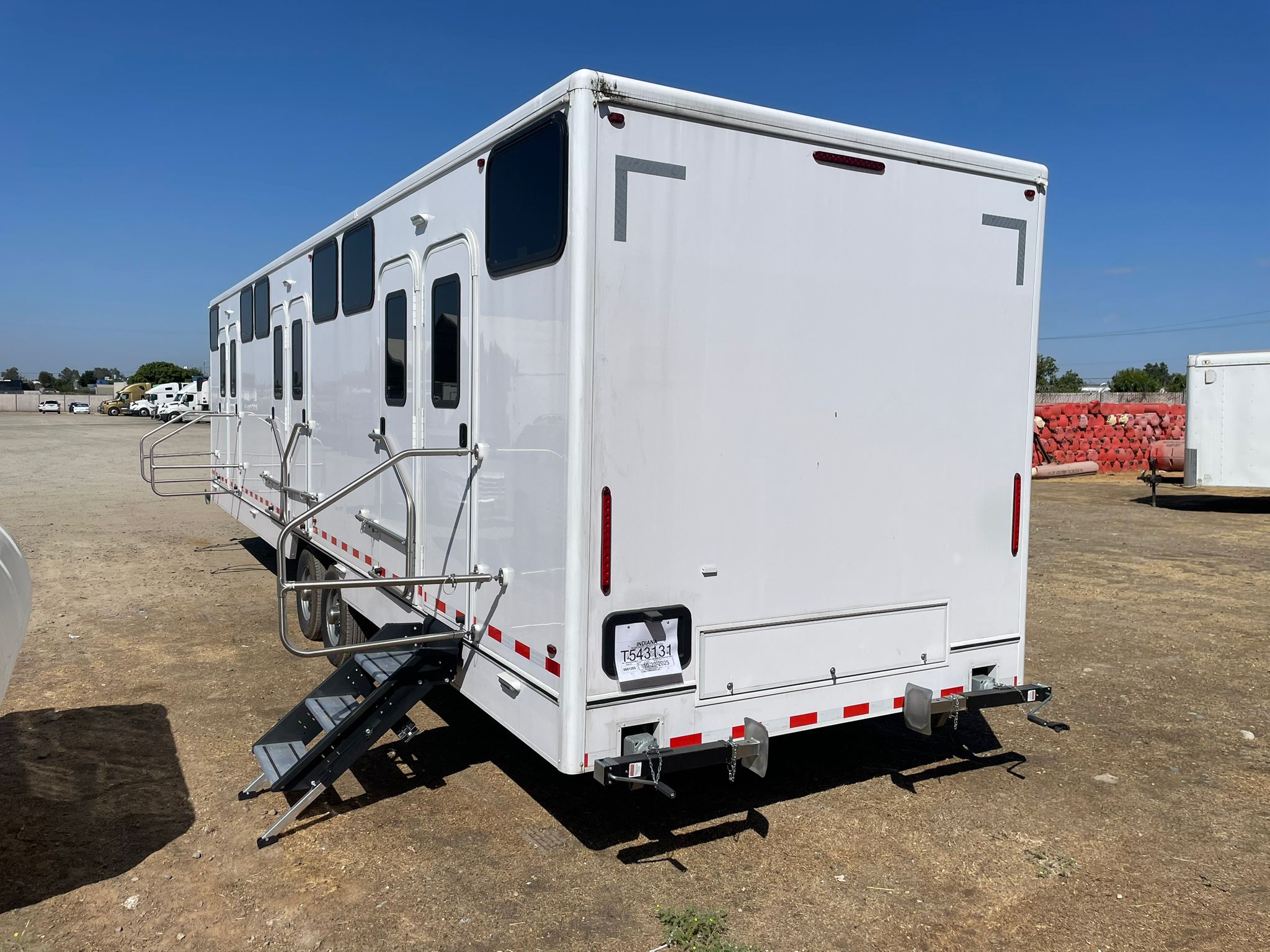

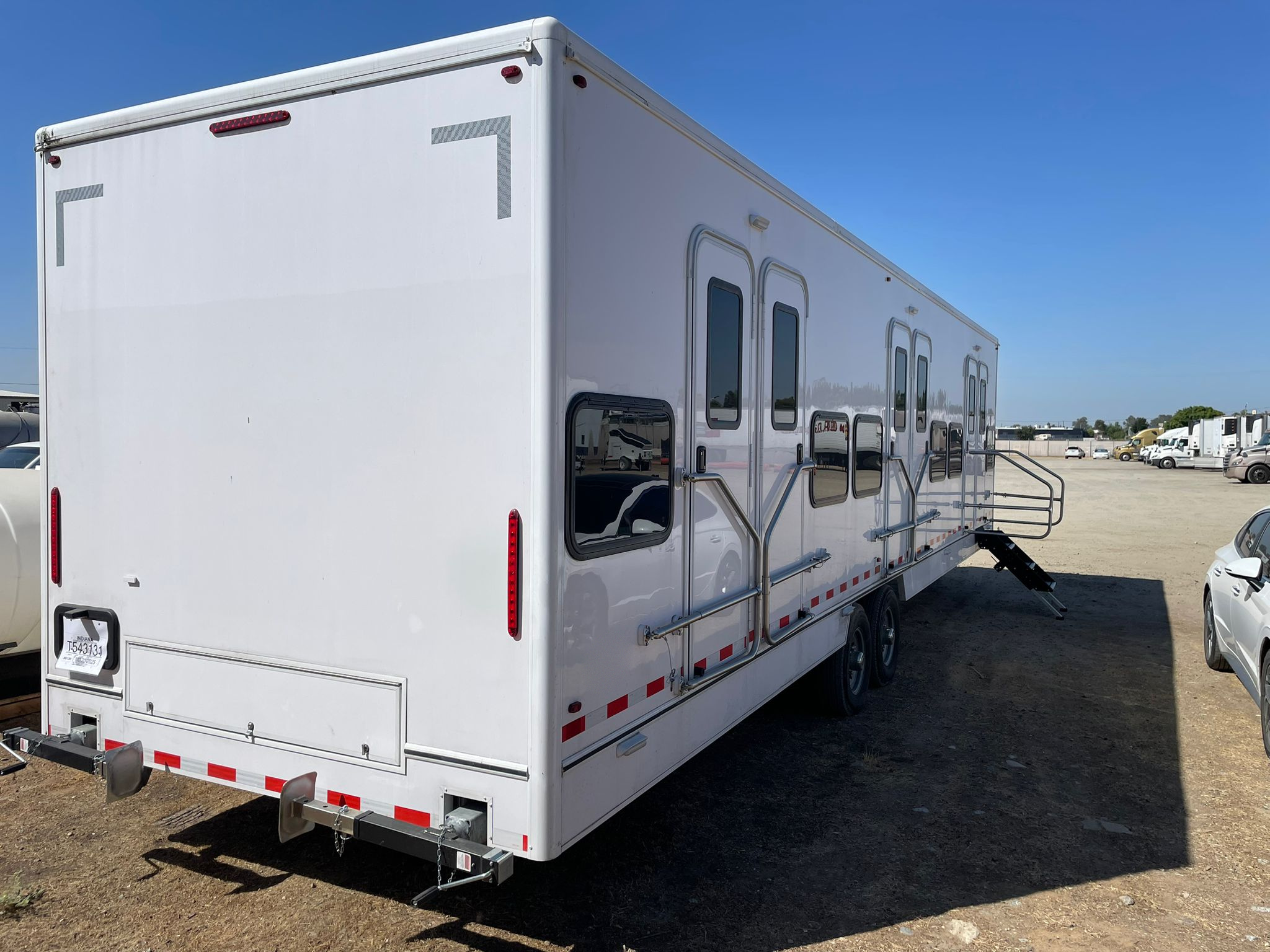

34 ft bunkhouse sleeper trailer with three bunk entry doors and built-in steps
  • 12 bunks per trailer, 6 upper and 6 lower
  • 34 ft trailer delivered and set up on site
  • 3 AC units with heat and a smart thermostat
  • 24/7 dispatch at (888) 828-7765
  • 12,000+Trailer deliveries across our network
  • 50Delivery to all 50 states
  • 24/7Dispatch answers day and night
  • 12Private bunks in every trailer

Built for construction crews, fire camps, pipeline spreads and utility contractors.

Built for working crews

A crew sleeper trailer with 12 beds and 3 AC units, set up before your crew arrives

Crew bosses call us when the nearest open hotel is an hour out or fully booked. Across our network we have logged over 12,000 successful trailer deliveries, and that practice shows in the small things. We answer at night. We ask about gate width and the power hookup before the truck ever rolls. The sleeper arrives level and ready, already cooled or heated for a tired crew. Call (888) 828-7765 to talk it through with a real person, or request a crew housing quote with your dates and headcount.

The 12-Station Bunkhouse Sleeper Trailer is a 34 ft crew quarters trailer with 6 upper and 6 lower bunks. Every bunk gets its own LED light and USB outlet, plus a storage compartment.

What comes with every rental

  • Delivery, leveling and setup by our driver
  • Twelve private bunks, each with a light, USB outlet and storage
  • Three AC units with heat and a smart thermostat
  • Built-in steps at every bunk bank
  • Pickup when the job wraps

No surprises

One 34 ft bunkhouse with twelve real beds

Every rental is the same proven unit, so your crew knows exactly what they are walking into.

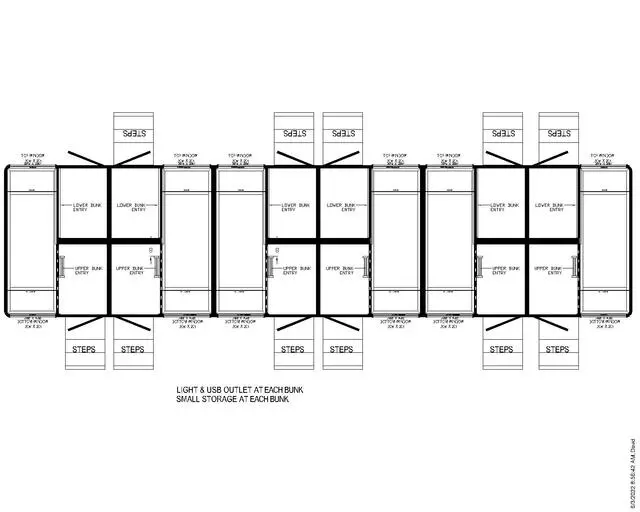

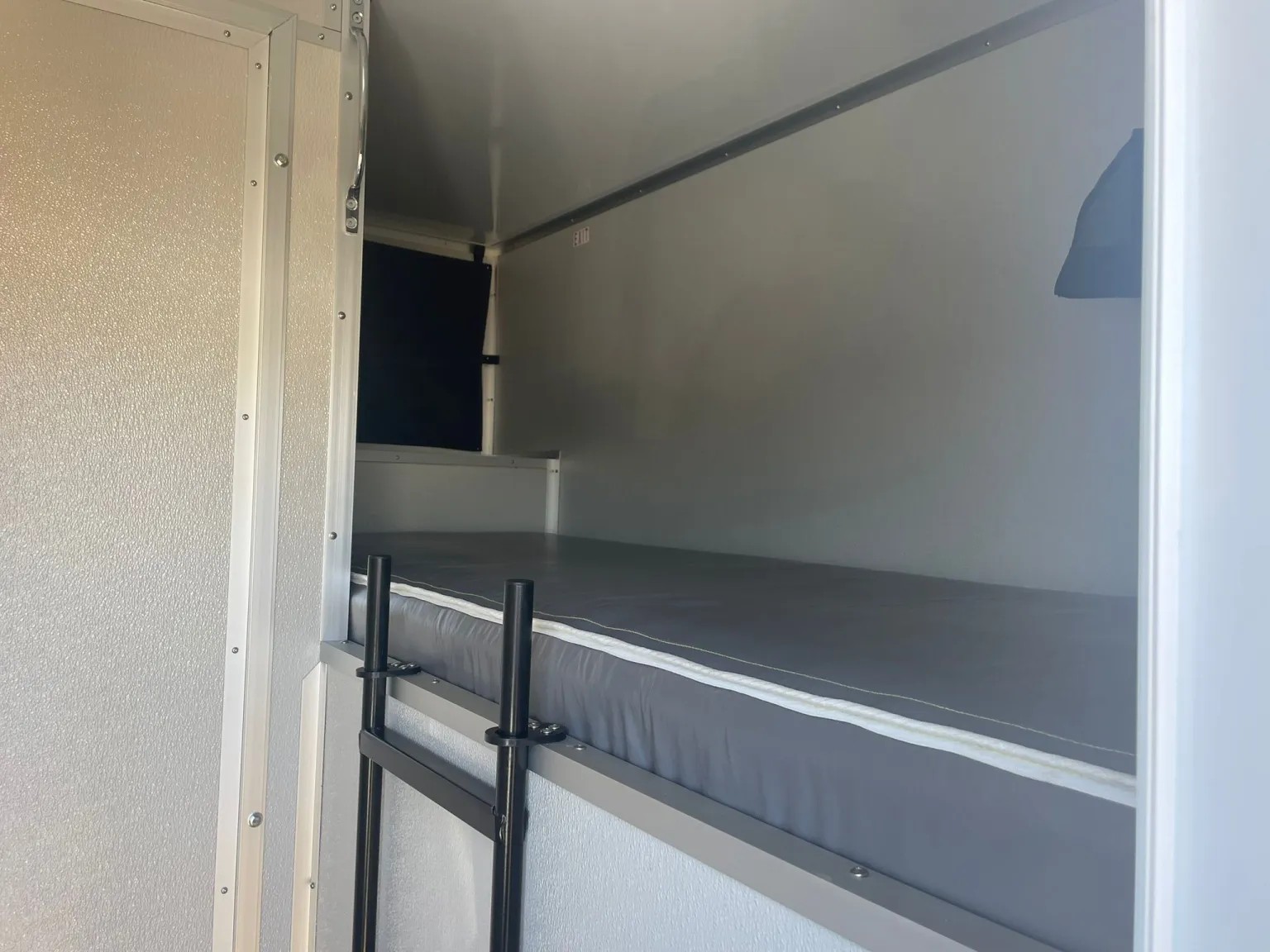

Inside, the layout is simple. 6 lower bunks sit under 6 upper bunks. Built-in steps at each bunk bank make the top row easy to reach at 4 a.m., work boots or not. Each of the 12 bunks has its own LED light, so one worker can check tomorrow's shift schedule without waking the 5 people stacked around him. Phones charge at the bunk from a USB outlet instead of fighting over one strip by the door. A storage compartment at every bunk keeps keys, a wallet and a headlamp off the floor.

3 AC units with heat cover both ends of the calendar. Set it once. A smart thermostat with digital touch control lets the crew pick one steady temperature and leave it there, whether that is a West Texas pad in July or a bridge job in North Dakota in November. Day sleepers get a closed, climate-controlled room while the rest of the site keeps working outside in the noise and the heat. A hot, bright tent wears down a crew coming off an 8-hour night shift, and a heated, air-conditioned bunk room is our answer to it.

We haul the trailer to your site and back it in. Then we level it. Then we set it up and test the heat and the air before we ever leave the pad. It needs level, well-drained ground and a road wide enough for a truck pulling a 34 ft trailer to clear the gate. When the work moves, the sleeper moves with it, which is why pipeline crews and fireline crews pick a portable bunk trailer over a camp that takes months to build. Send the full bunkhouse trailer spec sheet to your safety lead before you book, so the hard questions get answered on the first call instead of on delivery day.

Bunkhouse and mobile sleeper trailers across the industry commonly ship in 8, 12, and 16-person configurations, with the wider category of specialty units running anywhere from 17 to 42 ft depending on the manufacturer. Our 34 ft, 12-bunk configuration sits at the standard, proven end of that range instead of an unusual outlier, which matters when your safety lead is comparing our spec sheet against somebody else's.

Spec plate

12-bunk sleeper
Bunks6 upper + 6 lower = 12 total
Sleeps12 people
Length34'
Per-BunkLED light, USB outlet, storage compartment
AccessBuilt-in steps at each bunk bank
AC Units3 (HVAC, smart thermostat)
ClimateAC & Heat, digital touch control

Need beds on site this week?

(888) 828-7765

A real dispatcher answers 24/7. Tell us where the crew is and when they start.

In practice

What renters tell us after the first week

"We had 30 guys on a pipeline spread and the nearest open rooms were an hour out. The sleepers showed up leveled and cold inside the day before our crew change. Nobody asked about the motel again."

L. P.Pipeline superintendent

"Our night shift finally slept. Base camp ran generators all night, and the trailer shut that out. The bunk lights and USB outlets ended the fight over the one power strip."

L. N.Camp logistics lead

"After the ice storm every hotel in the county was full of families. Dispatch answered at 11 at night and had two sleepers on our yard with the heat running. My lineworkers walked from the bucket trucks to their bunks."

D. L.Utility restoration supervisor
Delivering to all 50 states

Short version

Delivered to any job site in the country, step by step

From a pipeline yard in West Texas to a fire camp in the Oregon Cascades, we route a trailer and a driver to where your crew is working, remote and off-grid sites included.

What crews ask

The ground our drivers already know

Nothing fancy

What sets our bunkhouse trailers apart, explained

  • Twelve private bunks

    Six upper and six lower, each its own space. No cots, no shared air mattresses.

  • Heat and air, three units

    Three AC units with heat and a smart thermostat keep the trailer comfortable in July and January.

  • Light and USB at every bunk

    Each bunk has an LED reading light, a USB outlet and a storage compartment for phones and gear.

  • Delivered and set up

    Our driver hauls it in, levels it and walks your lead through it. You do not need a truck or a hitch.

  • All 50 states

    We plan routes to remote yards, fire camps and storm zones anywhere in the country.

  • 24/7 dispatch

    Call at any hour and a person picks up. Crews change plans at night, and so do we.

In short

How a bunkhouse rental actually runs

  1. Call or send a quote request

    Tell us the site, the crew size and your start date. We answer 24/7.

  2. Plan the drop

    We confirm site access and power, then lock in a delivery window.

  3. Delivery and setup

    Our driver places the trailer, levels it and hands your lead the keys and a walkthrough.

  4. Pickup when you wrap

    Extend as long as you need. When the job ends, we haul it out.

Construction and plant shutdowns

Bunkhouse trailers for construction crews and plant shutdowns

Heavy-civil construction lands far from town by its nature. Highway bridges and wind farms both put crews on pads where the closest hotel accommodation sits a long drive away. After a 10 or 12 hour shift, that drive back is the most dangerous part of the day. In one survey, 45 percent of construction employers blamed worker fatigue for safety-related incidents on their sites, a figure the National Association of Home Builders flags as a documented jobsite hazard. A sleeper trailer on the pad eliminates the commute entirely, and our construction crew bunkhouse trailers page covers megaproject staging arrangements in more depth.

Most outdoor building in this country runs from about April through October. That is a 7-month window, and it packs nearly a full year's housing demand into it. The good trailers get booked early in that window, not late. We tell project managers to lock down housing the same week they lock down the crane. A crew that knows where it sleeps on night one shows up ready on day one.

Plant shutdowns are a different kind of rush. A refinery or chemical plant takes a unit offline for inspection, maintenance and repair work, and the workforce can double or triple in a matter of weeks. A major turnaround can bring 1,500 to 2,000 contract workers onto one site at once. Industry coverage of these turnarounds consistently names modular buildings and mobile offices as the standard solution for housing that sudden surge workforce, sleeping included, when the surrounding town cannot absorb it. The date is set months ahead, yet the local hotels still fill up the same week, every time. Laydown space is tight inside a live plant, so we plan our placement beside the mobile offices before the truck ever rolls.

The priority on these jobs is plain. The superintendent wants the crew rested and on site at first light, not stumbling in off an hour-long drive. A clean, quiet bunk room is part of how you keep good hands through a long job. Associated Builders and Contractors puts the industry's worker shortfall at several hundred thousand people a year, and a crew with nowhere good to sleep is a crew that takes the next offer down the road instead. Renewable-energy construction on wind, solar and battery-storage sites tends to land on greenfield or semi-rural ground with no nearby town at all, and those projects plan crew housing around trade, phase, shift and rotation headcounts as part of the execution plan itself, not as an afterthought bolted on once the crew has already arrived. Substation and switchyard construction, transmission-line corridors and utility-scale interconnection work follow that same greenfield logistics pattern, which is why procurement teams across renewable energy, transmission and traditional construction increasingly source crew housing from the same regional providers, coordinating delivery schedules, generator sizing and climate-control specifications through a single point of contact rather than negotiating separately with multiple regional subcontractors for every individual project phase. A temporary sleeper costs you nothing in commute hours once it is set and running. If your work falls outside building, our crew housing by industry list covers the rest.

  • Highway and bridge projects
  • Wind and solar farm builds
  • Transmission line routes
  • Dam and reservoir work
  • Water and wastewater plant builds
  • Refinery and chemical plant shutdowns
  • Data center and factory megaprojects
Industrial workforce crew at a jobsite

Oilfield and pipeline work

Crew quarters trailers for oilfield and pipeline crews

Oil and gas crews know the hotel problem better than anyone. At the peak of a Permian boom, Guy Andrews of the Odessa Chamber of Commerce reported 100 percent occupancy in apartments and hotels alike. Room rates climbed toward 250 dollars a night, with some rooms reported near 500, levels the local press compared to New York City. One major producer, Chevron, bought 10,000 hotel room-nights a year around Midland and Odessa just to house its own people. Target Logistics, a temporary workforce-housing provider, ran 14 lodges across North America totaling more than 5,300 beds during that stretch, with a single Eagle Ford, Texas location holding 302 beds on its own, and Stallion Oilfield Services kept roughly 200 more units working the Permian at the same time. A newer group called the Workforce Housing Standards Council now grades competing camp providers against a common health and safety bar. Our oilfield crew housing trailers go where those rooms run out.

Oilfield shifts often run 12 to 16 hours, 7 days a week. Reporting from the Texas Tribune and Texas Standard on Permian man camps quotes one temporary-housing chief ranking what workers care about most: food came first, and a good bed came second. The company usually makes the housing call, not the worker. That makes the person reading this page the one who hears about it when the beds are bad.

Pipeline spreads run on rotations like 21 days on and 7 off, with welders on 10 to 14 hour shifts. Federal pipeline guidance from the Pipeline and Hazardous Materials Safety Administration describes contractors placing temporary trailers and staging yards before pipe ever goes in the ground, with those yards cleared and strategically located to stockpile pipe, store fuel tanks, sandbags, silt fencing, stakes and equipment parts alongside the crew's sleeping quarters. The work then moves down the right-of-way week by week. A built camp stays put. A portable crew sleeper trailer does not, so it can move down the line with the spread, mile by mile. We plan each move around crew change, so nobody loses a night of sleep to the haul.

On a gas pad, we set sleepers so the wind blows away from the wellhead, and on higher ground too. A heavy gas can settle in low spots close to a well, and nobody should sleep in one of those spots. Remote mines often run FIFO rotations instead, flying crews in and out on a fixed roster rather than housing them full time. A big built camp makes sense for a mine that runs for decades and supports several thousand workers at once. For a short exploration program, or a shutdown at a remote processing mill, a few delivered sleepers house the crew far sooner than a multi-year camp construction project ever could.

  • Drilling and frac pads
  • Pipeline right-of-way spreads
  • Compressor station builds
  • Pipe storage and staging yards
  • Remote mine sites
  • Mill and processing plant shutdowns
Daytime land oil drilling rig in a desert canyon setting

Wildfire camps

Heated and air-conditioned bunk trailers for wildfire camps

A large incident base camp has what a crew needs on paper, from food tents to a sleeping area. Crews who have lived in one tell a different story. Generators run all night. The lights stay on. Night crews walk through camp while day crews try to rest 20 feet away. A closed, climate-controlled sleeper shuts most of that out, and our wildfire fire camp bunkhouse trailers page covers base camp layout in detail.

When the fireline sits too far from base, crews spike out to a smaller camp close to the line instead. Agencies treat that shorter trip to bed as a safety control, not a comfort. Conservation camps such as Oak Glen Camp in Southern California describe their own role directly as shelter and subsistence for crews traveling in from other regions entirely, which is exactly the visiting-crew problem a delivered sleeper trailer solves anywhere in the country. A sleeper trailer can go to a spike camp site whenever the road in can take a truck. It gives the crew a real bed behind a real door, instead of the ground.

Crowded camps also spread sickness, which crews call camp crud. In one investigated fire camp outbreak, 49 of about 180 responders got sick with the same stomach bug. Recent guidance across fire agencies on sickness during fire operations calls for thinning out camps and running smaller ones. 12 bunks behind a closed door is a much smaller group than an open sleeping area for 180 people.

Fire season runs roughly May through November, with August as the national peak. Parts of California now carry fire risk most of the year. Governor Newsom's office confirmed 9 active wildfire base camps running across California in early August 2026 alone, a season that started early after mountain snowpack came in at just 18 percent of average. By late September 2026, the National Interagency Fire Center had logged 56,908 wildfires and 1,824,164 acres burned for the year, with 8,523 personnel assigned to active incidents at that same snapshot, and the longer historical average sits near 70,025 wildfires and 7 million acres burned annually since the year 2000. Fire orders come with little warning, so our dispatch line stays open around the clock through that whole stretch.

  • Incident base camps
  • Spike camps near the fireline
  • Fairgrounds used as command posts
  • Conservation crew camps
  • Helibase and staging areas
  • Utility wildfire mitigation work
Wildland fire hand crew on a fireline trail

Disaster response and storm crews

Mobile sleeper trailers for disaster response and storm crews

Debris and utility crews roll in as soon as the roads open. The hotels they would use are often closed, or already full of families who lost their homes. Months after Hurricane Helene, over 4,500 people across 25 counties were still in FEMA's Transitional Sheltering Assistance program. In Puerto Rico after an earlier major storm, many hotels stayed closed or full with emergency responders and crews working to restore the power grid. Responders end up competing with those same families for the same rooms. Our disaster response sleeper trailers page covers base camp staging after a storm.

When no one plans housing, workers sleep in their trucks. A Center for Public Integrity investigation, published under the title Toxic Labor, found cleanup workers after Hurricane Ian sleeping in cars and tents behind a dollar store in Fort Myers. One worker, identified only as Michelle, slept in her Toyota Sienna van and scrubbed off the day's dust with no shower, and OSHA site-inspection visits after that same storm were reported at just 15 minutes per worksite. Another, a worker named Joel, told investigators he had cleared debris from 18 hurricanes, floods and wildfires across 4 states over 5 years, moving from disaster to disaster with nowhere fixed to sleep. After Hurricane Katrina, a worker named Santos described living in a crowded dormitory alongside hundreds of other rebuilding workers, which is its own kind of overcrowded, disease-prone housing failure rather than a real fix. That is the bottom of the ladder, and a crew stuck there for even a week does not stay long.

Utility mutual aid moves lineworkers across state lines in a matter of days, coordinated through networks like the American Public Power Association, which counts more than 2,000 public power and cooperative utilities as members. ElectriCities alone reported roughly 30 crews deployed among its member utilities for Hurricane Helene restoration, part of a broader multi-state restoration force that other coverage put at more than 7,300 workers arriving from 27 states combined. Storm crews often sleep in shifts, so day sleepers need a dark, cool room. They also need parking for bucket trucks close to the bunks. We place mobile sleepers so the trucks can stage right beside them, and the crew walks 30 feet to bed instead of driving an hour.

Atlantic hurricane season runs June 1 to November 30, with its statistical peak around September 10. That lands right on the tail of fire season and the busy end of building season. Short notice is normal in this work, sometimes a single day. Our 24/7 dispatch line is there for the call that comes the night before landfall.

  • Debris staging and reduction sites
  • Utility storm restoration yards
  • County fairgrounds and emergency compounds
  • Flood recovery zones
  • Ice storm restoration routes
  • Hurricane response base camps
Disaster response worker clearing debris

How to Plan Crew Housing for This Work

Planning housing for crews, camps and remote job sites comes down to four questions: the headcount sleeping on site, the expected length of the assignment, the electrical capacity available at the pad, and delivery access for a truck and trailer. The sections below work through each question in order.

How a portable bunkhouse trailer gets placed and set up

We deliver before the crew arrives, not the same afternoon they land. That gives us daylight to level the trailer and test the climate system before anybody needs to sleep in it. If your crew rolls in on a Sunday night, the sleeper should be cool and lit by Sunday afternoon, 4 hours ahead at least. One workforce-housing provider in this market has cited a 96-hour outer bound to deploy, install and connect 306 beds in a true emergency scenario. We plan to beat that on most jobs. For disaster work, we move as soon as the roads can take a truck, sometimes within a day of landfall.

Pick level, well-drained ground that does not hold water after a storm. Keep the sleepers a short walk, 100 feet or so, from the restrooms, but away from generators and haul roads. A laydown yard with gravel or timber mats works well. Soft ground after heavy rain can let a trailer settle out of level, so tell us about drainage on the first call, not the third.

The trailer runs on site power or a generator. 3 AC units draw real power on a hot afternoon, so we confirm your hookup before delivery day instead of guessing at the panel. If the site has no power yet, say so on the first call. We will talk through generator sizing with you, in kilowatts, before the truck is loaded.

When the job moves, the sleeper moves with it. Pipeline crews and fire crews often need this, and we schedule each move between shifts so the off crew never waits on a bed. Most camps pair the sleepers with separate restroom and shower trailers, so we time our drop to fit the rest of your camp layout, down to the walking path between them. At the end of the job, we pick up and leave the pad clear, usually inside a single day.

Industry descriptions of pipeline mobilization camps list the standard components a full setup usually includes: accommodation units, a site office, a dining or kitchen unit, sanitary containers, a laundry room, first-aid space, storage, and often a security cabin at larger sites. A sleeper trailer is one piece of that coordinated arrangement, not the whole solution, which is why we ask early about what else is already on order for your site.

  • A level, well-drained spot longer than the 34 ft trailer, plus room to back in
  • A road and gate a truck can clear with a 34 ft trailer in tow
  • Site power or a generator plan, confirmed before delivery day
  • A named site contact whose phone answers on delivery day
  • Walking distance to restroom and shower trailers
  • Clear dates for crew arrival and pickup, plus each crew change
Crew standing at a jobsite
Crew standing at a jobsite

How many crew sleeper trailers your headcount needs

ScenarioCrew sizeTrailers
Survey team or small specialty crewup to 12 people1 trailer
Standard field crew with room for late hires20 people2 trailers, 4 open bunks
Two full crews on one pad24 people2 trailers
Plant shutdown or bridge job crew36 people3 trailers
Full roster sleeping on site at once60 people5 trailers
60-person roster on a 7-on, 7-off rotation30 on site3 trailers, 6 open bunks
60-person roster on a 21-and-7 pipeline rotation45 on site4 trailers, 3 open bunks

The base math is simple division. Do the division first. One trailer sleeps 12, so a 24-person crew needs 2 trailers and a 36-person crew needs 3. A 20-person crew also needs 2, which leaves 4 open bunks for a late hire or a visiting inspector. Round up, never down. A worker without a bunk ends up back in a hotel on his own dime, and the office ends up coordinating two separate housing plans instead of one.

Rotation changes the calculation more than anything else. On a 7-on, 7-off schedule, only half the roster sleeps on site at once. A 60-person roster therefore needs bunks for 30, and 3 trailers cover it with 6 to spare. On a 21-and-7 pipeline rotation, roughly 3 quarters of the crew is on site at any given time, so that same 60-person roster needs 4 trailers instead. Watch crew-change day closely. Incoming and outgoing crews can overlap for a night or two.

Hot-bunking is the other lever, borrowed from naval and offshore practice. Two 12-hour shifts can share one set of bunks, so a single trailer can sleep 24 people across a full day. Crews that do this run strict protocols on changing linens, often weekly at minimum. Most crews we house keep one person per bunk instead, since shared bunks bring a laundry and sanitation problem with them. Tell us your shift plan. We will help you land the right count before you book, not after.

Rules that apply when you house crews in sleeper trailers

Crew housing sits inside a handful of real regulations, and the employer running the camp carries most of that responsibility. We deliver the trailer. We set it up. Your safety lead decides how each rule applies to your job, and we hand over the documentation they need to make that call.

The federal standard for temporary labor camps is OSHA 29 CFR 1910.142. It asks that a camp site be well drained and not subject to periodic flooding. It also sets specific requirements for what the shelters must provide, room by room. It also asks the camp superintendent to report any outbreak of illness to the local health officer immediately, not at the end of the week.

On wildland fires, National Wildfire Coordinating Group work and rest guidance sets a 2-to-1 ratio. That means one hour of sleep or rest for every two hours of work or travel. Shifts cap at 24 hours. Standard assignments cap at 14 days before travel, extendable to 21 with an incident commander's documented approval. During National Preparedness Level 5, the highest activation level the interagency coordination system uses, personnel get 2 full days of rest after a 14-day assignment before any second reassignment, and military units supporting fire operations carry their own 30-day commitment ceiling. Camp managers plan sleeping arrangements around that regulation, which is exactly why a quiet bunk matters on a fire.

Crews who drive to a hotel each day face the same fatigue math on the road. Commercial drivers work under Federal Motor Carrier Safety Administration hours-of-service limits, generally an 11-hour driving cap inside a 14-hour on-duty window after 10 consecutive hours off, and a long hotel commute eats straight into those same hours. Local zoning can matter too. Midland, Texas treats a structure kept on a lot more than 180 days as a permanent installation under city code, which is why large camps there sit on county land instead. The National Response Team, a federal interagency body operating under the National Contingency Plan, has published its own dedicated guidance titled Guidance for Managing Worker Fatigue During Disaster Operations, confirming that fatigue management for disaster responders is treated as a documented federal hazard category, not an informal concern left to individual judgment. If your assignment will run long, mention it on the first call, not the last.

  • OSHA 29 CFR 1910.142, Temporary Labor Camps: Sets site and shelter rules for temporary worker camps, carried by the employer.
  • NWCG Work/Rest Guidelines: One hour of sleep or rest for every two hours of work or travel on wildland fire assignments.
  • NWCG assignment length limits: Standard fire assignments cap at 14 days, extendable to 21 with incident commander documentation.
  • FMCSA Hours of Service: Limits driving and on-duty hours for commercial drivers, which a long daily commute eats into.
  • National Response Team worker fatigue guidance: Federal guidance on managing worker fatigue during disaster operations.
  • Midland 180-day structure rule: Treats a structure kept on a property more than 180 days as permanent under city code.
Construction crew reviewing jobsite plans
Construction crew reviewing jobsite plans

What happens to crews without a bunkhouse sleeper trailer on site

Today the default plan is a block of hotel rooms. Someone in the office spends days on the phone chasing them down, and the rooms end up spread across 3 or 4 different properties in town. Then the crew burns an hour or more each way in pickup trucks, wrapped around a 12-hour shift. The federal government's own standard lodging reimbursement, the General Services Administration per diem rate, was set at 110 dollars a night for lodging plus 68 dollars a day for meals and incidentals, and the lodging figure is scheduled to rise to 113 starting October 2026, which gives a sense of how far behind an official benchmark can sit once a boom or a disaster hits a county's hotel supply. A government reimbursement schedule rarely tracks a boom-town hotel market in real time. A disaster-driven vacancy squeeze moves even faster than either one. Each can independently overwhelm the same limited local supply of rooms, which is precisely why procurement teams increasingly treat crew housing as its own line item instead of an afterthought folded into travel administration. In a boom or after a storm, the rooms are simply gone at any rate the office is willing to pay.

The next step down the list is a man camp, a term that entered common use during the Bakken oil boom in North Dakota and has stuck in the industry ever since. Big camps work well for a multi-year oil field. They also take a large build budget and months to stand up. One Permian camp, built by Goliath Industries at a cost sales manager Ed Parker put near 10 million dollars, sits on 52 acres and houses 1,250 workers, which fits a decade of drilling. It does not fit a 6-week plant shutdown, or a fire season that ends in October.

The bottom rung is the truck cab. During one Texas ice storm, 4 workers ran a truck engine all night just to stay warm until the sun came up. Crews on that plan burn out fast, and the good ones leave for a job that treats them better. West Texas counties around Midland, Odessa, Pecos and Orla can layer drilling-crew housing demand, pipeline-spread housing and, during Gulf hurricane season, disaster-response crew housing all in the same rough window, exactly the kind of overlap that catches an office without a standing housing plan off guard. A delivered sleeper with its own heat and its own door is the plain fix for all of it.

  • 2 hrs back each workday for a worker with a 1 hour drive each way
  • 10 hrs back per worker across a 5-day week
  • 120 hrs of weekly drive time back across one full 12-bunk trailer
  • 1 trailer in place of 12 separate motel rooms
Construction worker in a hard hat at a jobsite
Construction worker in a hard hat at a jobsite

Three sites and how a setup usually runs

Typical setup: pipeline spread, 60-person roster, 21-and-7 rotation, West Texas summer

On a pipeline spread like this, the superintendent often has hotel rooms booked in 2 towns, an hour apart either way. The job is sized at 4 trailers for the 45 people on site at once, not 5 for the full roster. Over 6 weeks, the sleepers can move down the right-of-way twice, with each move timed between shifts. The crew gets its drive time back, and the superintendent stops taking late calls about rooms.

Typical setup: wildfire spike camp, 20-person hand crew, late August

On a spike camp like this, the camp logistics lead needs beds closer to the line than the main base, where generators run all night. Two trailers go to a flat staging area on a forest road that a delivery truck can reach in under an hour. The day-sleeping crew sets the thermostat cool and sleeps through the afternoon. The 4 spare bunks can go to a relief engine crew that shows up on day 3.

Typical setup: refinery shutdown, 36 contract workers, 4 weeks in early spring

On a shutdown like this, the turnaround coordinator usually books housing the week the shutdown date is set, often 5 months ahead. Three sleepers go onto a gravel lot beside the mobile offices, inside the plant fence. Night-shift workers sleep through the day with the lights out and the air running at a steady 68 degrees. At the end of week 4, all 3 trailers can be picked up in a single day.

Aerial view of residential home framing construction
Aerial view of residential home framing construction

What you get

What crews ask before they book

Construction crew and cranes at a large commercial jobsite
Construction crew and cranes at a large commercial jobsite

How many people can sleep in one bunkhouse trailer?

12, one person per bunk. The trailer has 6 upper and 6 lower bunks, with built-in steps at each bunk bank. Every bunk has its own LED light and USB outlet, plus a storage compartment. If you run two 12-hour shifts that share bunks, one trailer can sleep 24 people across a full day.

How is a bunkhouse trailer different from a man camp?

A man camp is a large built facility, often with its own dining hall and security staff, planned for years of use and a large budget. A bunkhouse trailer is a single 12-bunk unit delivered and set up on your pad in a day. It fits jobs that last weeks or months, or crews that relocate. Many crews start with 2 trailers long before a camp could ever be built.

How fast can you deliver and set up a sleeper trailer?

It depends on the distance to your site and what the calendar looks like that week. Call (888) 828-7765 any hour. We will give you a real delivery date on the first call. We always aim to have the trailer leveled and running before your crew arrives. For storm and fire work, we move as soon as roads can take a truck, sometimes inside 24 hours.

Does the trailer need a generator, or can it run on site power?

It runs on either one. Many sites have power at a pedestal or a nearby building, while remote pads usually run a generator. 3 AC units draw real power on a hot day, so we confirm the hookup before delivery and help plan a generator, sized in kilowatts, when the site has no power yet.

Does the sleeper trailer have a bathroom?

No. The trailer is laid out for sleep: 12 bunks, the climate system and power at every bunk. Crews use separate restroom and shower trailers set a short walk away instead. Tell us your headcount and camp layout, and we will time our delivery to fit the rest of your camp.

How do you keep a crew sleeper trailer warm in winter?

The same 3 AC units also run heat, and a smart thermostat holds one steady temperature. The crew sets it once on the digital touch control and leaves it there. For cold jobs, we set the trailer on ground that drains well so melt water does not pool underneath it. Let us know about freezing weather when you book so we can plan around it in advance.

How many trailers do I need for a 40-person crew?

If all 40 sleep on site the same night, you need 4 trailers. That gives you 48 bunks and 8 spares for inspectors or late hires. If your crew rotates and only part of it is on site at once, the count may drop to 3. Give us the rotation and we will run the math with you.

Can workers share a bunk across shifts?

Yes, it can be done. Day and night crews can share one set of bunks, which doubles what one trailer can sleep. It does bring a laundry and sickness burden, so plan a linen swap at every shift change. For that reason, most crews pick one bunk per person.

Can you move the trailer mid-project as the work moves?

Yes. Pipeline spreads and fire crews move all the time, and the trailer moves with them. We schedule each move between shifts so the off crew does not lose a night of sleep. Give us the new spot and the date as early as you can.

Can I rent a single 12-bunk trailer to start?

Yes. A 12-bunk trailer covers a crew of up to 12, and many small crews start there. You can add more trailers later if the crew grows. Call or send a quote request with your dates and headcount.

Are sleeper trailers available on short notice for disaster response?

Short notice is normal in disaster work, and our dispatch line runs 24/7 for exactly that. Call (888) 828-7765 the moment you know where your crew is headed. We will tell you what we can deliver and when, and the sooner we know the staging site, the sooner the trailer rolls.

Do you deliver everywhere in the country?

Yes. We deliver to all 50 states. The trailer arrives on our truck and gets leveled and set up on your site. Remote pads and staging yards are normal stops for us.

Can a mixed crew share one trailer?

Most employers give men and women separate sleeping space when a crew is mixed. The simplest way to do that is separate trailers. Tell us the split when you book, and we will size the order so everyone has a bunk.

What happens if a storm or fire cuts off the site after delivery?

Call our 24/7 line. We track road status with you and move or pick up the trailer as soon as a truck can reach it. Before fire or storm season, pick a spot with a second way out if your site allows it. The crew's safety comes first, and the trailer can wait.

Is there a minimum rental term for a crew housing trailer?

No fixed minimum. Some jobs need a trailer for 3 or 4 weeks between crew changes, and refinery turnarounds often run 4 to 6 weeks start to finish. Multi-year builds keep trailers on site for the full duration and swap headcount as the project moves through its phases. Tell us the rough length of your job and we will quote it accordingly.

Honest expectations

Reading for the person planning crew housing

  • Commercial building construction crane

    A week-by-week crew housing plan for a remote job

    Housing is usually the last line on the mobilization plan. It is the first thing crews complain about. It does not have to be that way. When a superintendent treats beds like any other piece of equipment on the schedule, the first night on site goes quietly. Here is the calendar we walk planners through when they call early, 8 weeks out instead of 1.

    Read the full note

    8 weeks out, pin down the headcount and the rotation. Write down the busiest night, not the average week. Note whether the crew is all on site at once, or rotating in halves like a 14-and-14 or a 21-and-7. This one number decides how many trailers you need, and it is the number most plans get wrong.

    6 weeks out, pick the spot. Walk it with the person who will run the camp day to day. Bring a tape measure and look for level, well-drained dirt with room to back a 34 ft trailer in. Check the gate width and any tight turns on the lease road. Look at where water sits after a hard rain. If the only flat spot on the whole pad is a low one, plan gravel or timber mats before delivery day, not after.

    4 weeks out, settle power. If the site has a pedestal or building power, find out exactly where it is and how far the trailer will sit from it. If not, line up a generator sized for 3 AC units and plan where it will sit, away from the bunks so the noise stays outside. Then book the trailers. In busy months the good dates go first.

    1 week out, name a site contact with a phone that actually answers. Share the crew arrival day and the date of the first crew change. Confirm where restroom and shower trailers will go, so the walk to them stays short and lit at night. Send the gate code, or the name of whoever opens it.

    Delivery day should come before the crew does, ideally the day before. We level the trailer and test heat and air, then check all 12 bunk lights one by one. The first crew should walk into a cool or warm room, not a trailer still being set up around them. After that, the plan is mostly about crew change. Mark those dates. Tell us if the job moves. Give us the pickup date once the end is in sight.

  • Road crew pouring and finishing concrete paving from a mixer truck

    How weather and day sleep shape a sleeper trailer plan

    Weather decides whether a crew sleeps well more than any other single thing on site. A tent works fine on a mild spring night. It fails hard in a desert July, or a January ice storm. That is why climate control is a safety item on a crew housing order, not an extra bolted on at the end.

    Read the full note

    Summer is the hard season for day sleepers, and it is where most sleep plans break down. A night crew comes off an 8 or 10 hour shift at dawn and needs to sleep through the hottest part of the day. An open camp is bright and loud by then, generators running, trucks moving. A closed trailer with its AC running gives that crew a cool, dark room at noon instead. Plan the placement so the door faces away from the busiest part of the site.

    Wildland fire agencies name this problem directly. National Wildfire Coordinating Group guidance calls cumulative fatigue a core safety issue on the fireline, driven mostly by lost sleep, not lost calories. It also lets supervisors stand crews down early when fatigue starts to hurt safety, before the 14-day cap even hits. The same logic holds on a pipeline spread or a storm yard. A crew that sleeps poorly for 2 weeks straight is a crew that starts making mistakes.

    Winter brings its own trouble. A cold metal wall sweats when the air inside is warm and damp, and wet bedding makes for a miserable night at 2 a.m. Insulation rated R-6 or better in the walls cuts that condensation down substantially. Steady heat helps, and so does a thermostat that holds one setting instead of swinging all night between 55 and 75. Keep boots and wet gear near the door rather than at the bunks. Ask the crew to crack the door as little as they can on cold nights.

    Shoulder seasons fool planners more than either extreme does. A fall job can see 80-degree heat in the afternoon and frost by morning, both in the same 12 hours. That swing is exactly where a smart thermostat with heat and air earns its place. The crew sets it once, and the trailer switches on its own as the night cools.

    Late summer and early fall stack several busy seasons on top of each other. Fire crews are still out while storm crews start moving in from 3 states away. Building crews push to finish before winter at the same time. If your job falls in that window, book housing earlier than feels necessary, weeks earlier. The trailers are the same all year, but the calendar is not.

    Source: NWCG guidance on sleep and fatigue

  • Construction site at sunset after the day shift wraps

    What to ask before you sign a crew housing rental

    Crew housing quotes can look alike on paper and play out very differently on the pad. The questions below come from what goes wrong on real jobs, not a sales script. Ask them of anyone you rent from, including us.

    Read the full note

    Start with who sets the trailer up. Some rentals drop the unit at the gate and leave. Ask whether the trailer arrives leveled and ready, with heat and air tested before the crew ever walks in. Ask who comes back, and how fast, if the ground settles after a rain and the trailer needs a reset.

    Next, ask what is at each bunk. A bunk with no light and no outlet means 12 crew members running cords and power strips across the floor. That is a trip hazard and a fight at 5 a.m. Ask whether every bunk has its own light and charging point, and where personal gear like boots and a helmet goes.

    Ask how the climate system is sized, because one small unit struggles to cool a trailer full of sleeping workers on a 100-degree afternoon. Ask how many units the trailer carries, and whether they also heat. Ask what power draw the trailer needs, in real numbers, so you can plan a generator or a hookup before delivery day.

    Ask about moves. If the work travels, you need a company that will move the trailer between shifts and keep the crew in beds the whole time, the same discipline the National Wildfire Coordinating Group expects from its own certified base and camp managers. Get the move process in writing, including how much notice they need and who handles the power hookup at the new spot. A move that costs the crew even one night of sleep undoes the whole reason you rented the trailer in the first place.

    Ask who answers the phone at night, because storms and fires do not wait for business hours. A dispatch line that answers at 2 a.m. is worth more than any glossy feature list. Finally, ask for the spec sheet. Send it to your safety lead before you sign anything. A good rental company will be glad to send documentation, no pressure attached.

Get a quote

Tell Us Where Your Crew Needs Beds

Send the basics and a dispatcher will call you back with availability and a delivery window. In a hurry? Call now.

  1. We confirm the site, dates and crew size.
  2. We lock in a delivery window and power plan.
  3. The trailer arrives, gets leveled and is ready for the first night.
(888) 828-7765

Request a quote

Takes about a minute. Fields marked * are required.

We only use your details to answer this request.
